How Long Does a Condo Renovation Take in Surrey, White Rock and Langley?

Estimated Reading Time: 7–8 minutes

This is one of the most consistently searched condo renovation questions - and it's also one of the most inconsistently answered. Ask three different contractors and you'll get three different answers, usually focused on the construction phase only and missing the factors that actually determine how long you're living without a functioning kitchen or bathroom.

The honest answer is that a condo renovation has more phases than a detached home renovation, and the timeline for each one is shaped by factors specific to strata living in Surrey, White Rock and Langley. Here's the realistic picture.

Why Condo Renovations Take Longer Than Detached Home Renovations

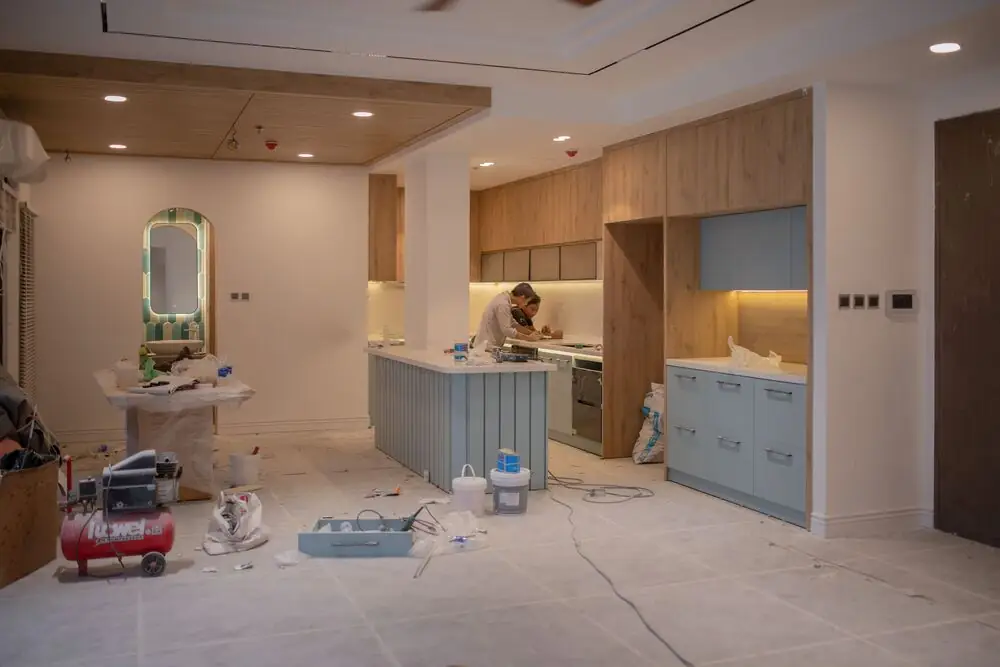

Condo renovation timeline bathroom kitchen Surrey White Rock Langley BC

Before getting into specific timelines, it's worth understanding why condo renovations have additional lead time built in by default.

You need strata approval before work begins. This is a separate process from permits, and it happens first. Your strata council must approve your renovation application before your contractor can book a single trade. Strata councils typically meet monthly, which means the timing of your submission relative to the next meeting significantly affects how quickly you can start.

Work hours are restricted. Most Surrey, White Rock and Langley strata buildings restrict construction noise to weekday business hours - typically Monday to Friday, 8am to 5pm or 9am to 6pm. No evenings, no weekends, no statutory holidays. This limits when trades can work and can extend the construction phase compared to the same scope in a detached home where scheduling is more flexible.

Elevator bookings are required for material deliveries and debris removal. Most buildings have one service elevator with limited booking slots. In busy renovation seasons - spring and fall - booking slots can fill two to three weeks ahead. This affects when materials can arrive and when debris can leave, which affects the overall project flow.

These factors are not obstacles - they're simply the context of renovating in a shared building. A contractor experienced in strata renovations in our area plans around all of them without it becoming your problem.

Pre-Construction Phase - The Part Most Timelines Skip

The pre-construction phase is everything that happens before demo begins. For a condo renovation in Surrey, White Rock or Langley, this phase is longer than most homeowners expect and runs four to twelve weeks depending on the scope.

Strata approval: Once you submit a complete renovation application package - scope of work, contractor credentials, insurance certificates, WorkSafeBC clearance, flooring specifications, and drawings if needed - the strata council reviews it at their next scheduled meeting. Simple cosmetic alterations may be approved in one to three weeks. Bathroom or kitchen renovations with plumbing changes typically take four to eight weeks. Structural changes requiring engineering review can take six to twelve weeks or longer. Submit early, submit completely, and have your contractor prepare the package professionally.

Municipal building permits: Building permits for any work involving plumbing, electrical, or structural changes run parallel to strata approval and need to be in hand before work begins. In Surrey, the MySurrey portal processes residential renovation permits averaging approximately five weeks. The City of White Rock Building Department (building@whiterockcity.ca or 604-541-2149) typically runs four to seven weeks. The Township of Langley processes smaller renovation permits in approximately two weeks. The City of Langley has similar timelines for straightforward applications.

Material procurement: Cabinets ordered to semi-custom specification take three to six weeks. Tile and stone can have lead times of two to four weeks for non-stock items. Vanities from quality suppliers typically run two to four weeks. All of these orders should be placed as early as possible - ideally before permits are even approved - so materials arrive on site as soon as construction can begin.

A contractor who starts the strata submission, permit applications, and material procurement simultaneously rather than sequentially compresses the pre-construction phase significantly. A contractor who waits for approval before ordering materials adds unnecessary weeks.

Construction Phase Timelines by Scope

Condo bathroom renovation (cosmetic - same layout): Two to three weeks of on-site construction once work can begin. Demolition, waterproofing, tile, vanity, fixtures, glass, electrical, and finishing. Straightforward scope when plumbing stays in the same positions.

Condo bathroom renovation (full renovation with plumbing changes): Three to five weeks of on-site construction. The additional time reflects the plumbing rough-in, required inspections at waterproofing and rough-in stages, and the sequencing of trades around those inspections.

Condo kitchen renovation (cosmetic - same layout): Three to five weeks of on-site construction. Demolition, cabinetry installation, countertop templating and fabrication (this alone takes ten to fourteen days after template, during which the kitchen is without surfaces), backsplash, flooring, lighting, and appliances.

Condo kitchen renovation (with plumbing or electrical changes): Four to seven weeks. The additional time reflects the rough-in work, permit inspections, and the coordination of multiple trades in a condo building where work hours are restricted.

Combined kitchen and bathroom renovation: Six to ten weeks of on-site construction. There are coordination efficiencies when trades are managing both rooms simultaneously, but the overall scope requires careful sequencing so that the two projects don't interfere with each other.

Full condo renovation (kitchen, bathroom, flooring, lighting throughout): Eight to fourteen weeks of on-site construction in most Surrey, White Rock and Langley condo units, depending on the size of the unit and the scope of trade work involved.

Condo Renovation Timelines

Realistic total from first consultation to completion, in weeks

Pre-construction (strata, permits, materials) Construction
  • Condo bathroom (cosmetic) 8–14 weeks
  • Condo bathroom (full) 10–18 weeks
  • Condo kitchen (cosmetic) 10–16 weeks
  • Condo kitchen (with trades) 12–20 weeks
  • Combined kitchen & bathroom 14–24 weeks
  • Full condo renovation 16–28 weeks
  • 0 wk7142128 wk

Where the time actually goes

2–10 wk

Construction phase

The rest

Pre-construction phase

Pre-construction is the long pole. Strata approval, permits, and material lead times are what make a condo timeline longer than a comparable detached home renovation, not the building work itself.

These ranges feel long at first. Planning for this timeline honestly from the start is the difference between a smooth process and a stressful one.

goldenvista.ca

What You Can Do to Speed the Process

Submit a complete strata application the first time. Incomplete applications get deferred to the next meeting, adding a month to your timeline. A professionally prepared package with every required document included processes faster and is approved at a significantly higher rate.

Apply for permits and strata approval simultaneously. Running these in parallel rather than in sequence can save three to six weeks.

Order materials before approvals are confirmed. This carries a small risk if the approval is denied or modified, but in the vast majority of straightforward condo renovation applications in Surrey, White Rock and Langley, approval is granted. Ordering materials during the approval window rather than after it can save two to four weeks.

Book the elevator as early as possible. As soon as you have a preliminary construction start date, book the elevator for material delivery and debris removal with building management.

Choose a contractor with strata renovation experience. An experienced contractor who has renovated dozens of condos in Surrey, White Rock and Langley knows this process and manages it efficiently. For guidance on choosing the right contractor, questions to ask a contractor before hiring them in Surrey and White Rock gives you the right questions to ask.

Final Thoughts

A condo renovation in Surrey, White Rock or Langley takes longer than most homeowners initially expect - not because the construction is slow, but because the pre-construction phase has real requirements that can't be rushed. Planning for the realistic total timeline from the start eliminates the frustration that comes from expecting a detached-home timeline and experiencing a strata-appropriate one. Start early, submit completely, and work with a contractor who understands how to manage strata renovation timelines efficiently.
